Gas Main Replacement Project 25

  • Contractor nameVeteran Pipeline Construction
  • Completion DateAugust 31, 2027

Project Description

The Natural Gas Main Replacement Project 25 will replace approximately 25,500 linear feet of natural gas mains and services with polyethylene (PE) pipe in neighborhoods of Duveneck/St. Francis neighborhood, Leland Manor neighborhood, and Midtown and Palo Verde neighborhood along Ross Road and crossing Matadero Creek and Barron Creek and is 100% grant- funded through the Natural Gas Distribution Infrastructure Safety and Modernization (NGDISM) Grant Program .

The project targets replacement of polyvinyl chloride (PVC) and black-wrapped steel (BWP) gas mains and gas services that are near their operational life expectancy, have become brittle over time, and are identified to be corroded.

Scope of Work

Replacing the gas distribution system with Polyethylene (PE) pipe in three various neighborhoods.

3 various GMR 25.jpg

Project Status

The Gas Main Replacement Project 25 began construction on February 23, 2026.

Veteran Pipeline Construction is the contractor for this work.

Area 1: Leland Neighborhood – Northampton Drive and Southampton Drive

Area 2 GMR 25
  • Construction for Leland Neighborhood’s Northampton Drive and Southampton Drive start on February 23, 2026.
  • Approximately 5,850 ft of PE pipe was installed, including new services and service reconnect stubs on Newell Road, West and East Greenwich Place, and the West and Eastside of Northampton Dr and Southampton Dr. Installed pipelines and services are in service as of June 11, 2026.
  • Restoration of street paving and removal of markings were completed on August 24, 2026.

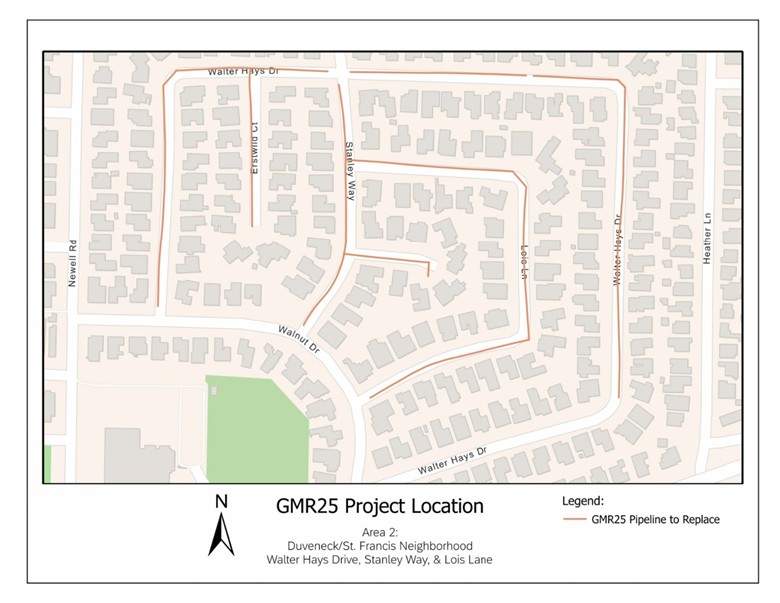

Area 2: Duveneck/St. Francis Neighborhood – Walter Hays Drive, Stanley Way, and Lois Lane

Area 2 GMR 25
  • Construction for Duveneck/St. Francis Neighborhood’s Walter Hays Drive, Stanley Way, & Lois Lane started on June 15, 2026.
  • Approximately 5,820 ft of PE pipe was installed, including new services and service reconnect stubs on Walter Hays Drive, Stanley Way, Lois Lane, Erstwild Court and Jordan Place. Installed pipelines and services are in service as of September 3, 2026.
  • Restoration of street paving and removal of markings were completed on September 21, 2026.

Area 3: Midtown and Palo Verde neighborhoods - along Ross Road and surrounding streets.

Area 3 map
  • Installation of approx. 400 ft of pipeline under the creek crossings for Matadero Creek and Barron Creek was completed on July 29, 2026.
  • Area 3 – Part 1 construction started on August 3, 2026 and approximately 3,240 ft of PE pipe was installed, including new services and service reconnect stubs. Installed pipelines and services are in service as of October 20, 2026.
  • Area 3 – Part 2 is anticipated to complete installations of approx. 2,695 ft of gas main, including new services and service reconnect stubs on November 9, 2026.
  • Area 3 – Part 3 is anticipated to start on November 11, 2026 which includes Loma Verde, and Middlefield Rd. The remaining areas of Midtown Neighborhood’s Ross Road will be scheduled as the project progresses.

The anticipated completion date for the GMR 25 project is August 31, 2027.

Work hours will be Monday through Friday, 8 a.m. to 4:30 p.m. Restricted work hours will be applied to school routes and bike lanes for the duration of the project.
